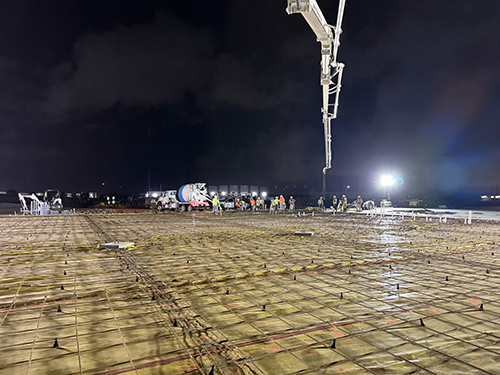

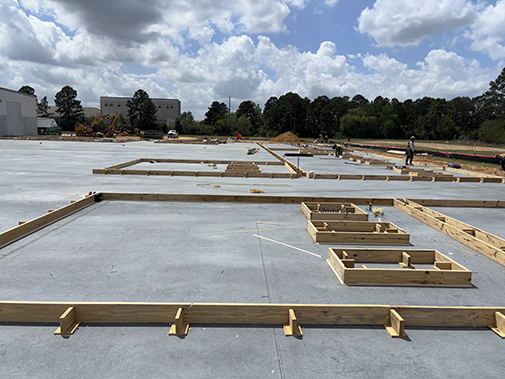

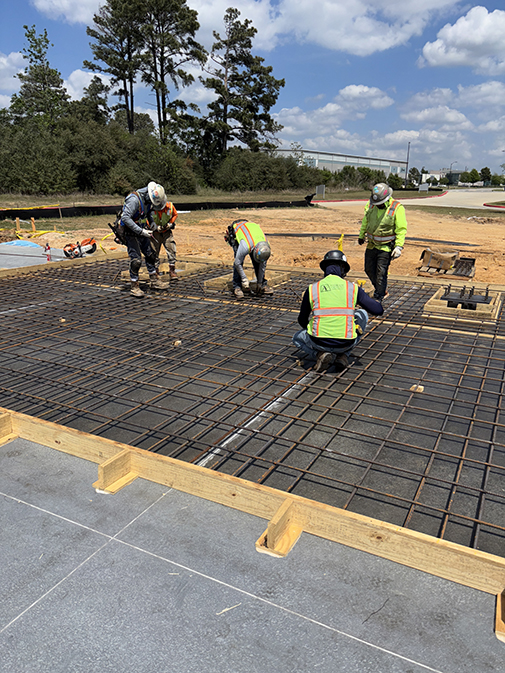

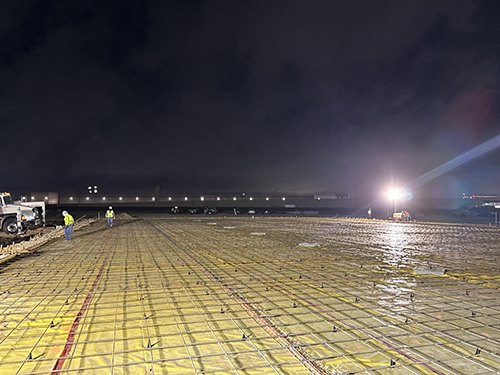

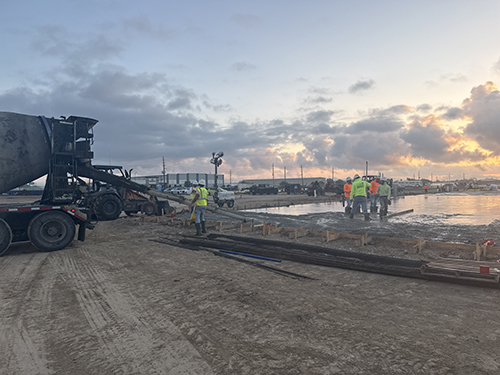

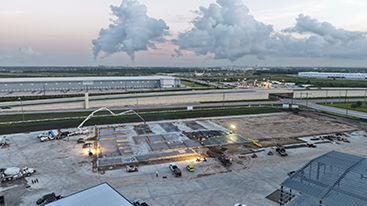

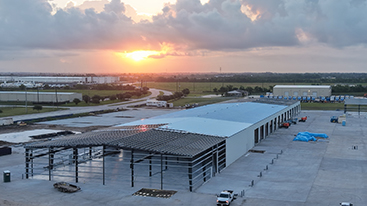

11.03.23 - The slab is poured for the new 12,000 SF expansion of their Friendswood location. The concrete crew is laying out the paving and the erectors will begin hanging steel next week.
10.25.23 - Interior crews are hanging sheetrock. Concrete crewmen are getting ready to pour the equipment pad,
7.25.23 - Crews poured the foundation this morning.
7.20.23 - Crewmen are preparing for next week's pour,
5.25.23 - Crews are breaking ground on Big City Manufacturing's new facility in Industry Park. This Design/Build project includes a fully air conditioned shop and 3,000 SF of finished office space,
10.04.23 - The landscaping is scheduled for this week, and the power is to be turned on this week.
4.20.23 - The last of the paving was poured last night. Erectors continue to sheet the buildings,
3.22.23 - Erectors began hanging steel this week. Half of the paving was poured this morning,
10.13.22 - Site crewmen broke ground this week on the Katy Industrial Condos. Crewmen have scraped the site and are beginning the pads,
9.22.22 - Our crews are breaking ground this week on a new Industrial Condominium project in Katy, TX. Two 11,830 SF units are under construction in the Katy-Hockley Business Park Development (4107 and 4109 Katy Hockley Rd). The condominiums will total 23,660 SF and will be ready Q2 2023.
7.17.23 - The stucco and stone is complete. Crewmen are installing glass.
4.14.23 -The masons started their work on the stucco. This project is on schedule to be completed in May.
3.01.22 - Erectors continue to hang steel. The framing crews began framing the front facades. The paving crew will start pouring the paving soon,
12.02.22 - Crews began sheeting the buildings,
11.17.22 - Crews are erecting the first of the 12,000 SF flex office/warehouse spaces,
11.06.22 - Crewmen poured the first pad for this project. Spaces are available for sale or lease and range from 3,000 SF to 12,000 SF.
7.17.23 - Site crews began to scrape the site for the third phase of the Independence Business Park for Finial Group. We are building three office / warehouse buildings total (Building 2, Building 6, and Building 7, each being pre-engineered metal buildings with horizontal architectural panels and limestone offices. Bldg 2 will be 46,378 SF with a 2,855 SF office. Building 6 will be a 18,525 SF crane-ready building with a 2,025 SF office, and Building 7 will be a 25,425 SF crane-ready building with a 2,025 SF office.
5.25.23 - Interior crews continue to hang sheetrock. The paving crew is laying out the remainder of paving to be poured,
3.08.23 - Erectors completed their work hanging the steel. The fire sprinkler contract are hanging pipe. The dirt crewmen are cutting grades,
2.08.23 - M&M Erectors are hanging steel for the new facility,
1.17.23 - Crews are pouring the foundation for Humble Sign’s new 35,722 SF facility. Their new facility includes a two-story office and a crane-served warehouse for manufacturing. We built for Humble Sign in 2018 and are excited to be working with them again.
4.14.23 - Crews are hanging steel for the next storage unit,
3.01.22 - The first two buildings are fully sheeted and trimmed. Sheeting continues on the third storage unit,
12.02.22 - This boat and RV storage park will include 100,000 SF of storage within a total of 13 buildings. The first two buildings are poured,
3.09.23 - We enjoyed being a part of Webb's Automotive ribbon cutting yesterday featuring their new expansion,
1.27.23 - Erectors trimmed the new expansion,
11.18.22 - Crewmen poured the foundation for Webb's Automotive's new oil service center. We built Webb's Automotive's origional auto repair and oil change service facility 11 years ago. It is such a blessing to be doing additional work for past customers,
10.13.22 - Erectors are getting close to closing in the South end of the building,
9.29.22 - Exterior sheeting and interior insulated sheeting are underway,
9.27.22 - Additional paving is poured. M&M Erectors have erected the steel and are installing the wall sheeting,
9.22.22 - Erectors are assembling and lifting the roof sections,
9.19.22 - Erectors are shaking out the steel,
7.06.22 - This project is complete,
6.02.22 - Masonry work is underway, in addition to electrical and the office build-out,
5.11.22 - Canopies are being installed. M&M is trimming out the wash bay building. The asphalt drive is complete,
3.18.22 - Erectors continue to sheet the building. The concrete crew is scheduled to pour the parking lot next week,
3.02.22 - Erectors continue to hang steel. The pre-assembles are complete and crews are filling in the intermediate bays,
2.15.22 - Erectors are hanging sections of roof,
1.19.22 - Crews are pouring the second half of the foundation,
11.11.21 - Site work is underway for Elite RV's new 70,000 SF conceirege service storage center for motorcoaches,
7.06.22 - The pad and utilities are complete. Crews will begin drilling the piers this week,
5.16.22 - Sitework continues,

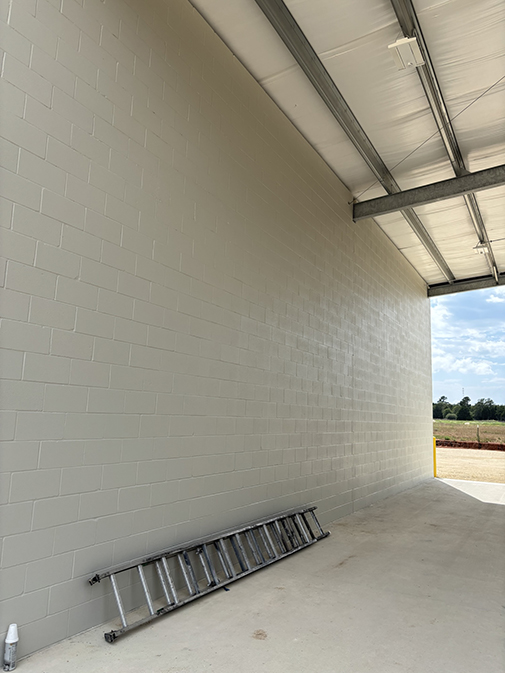

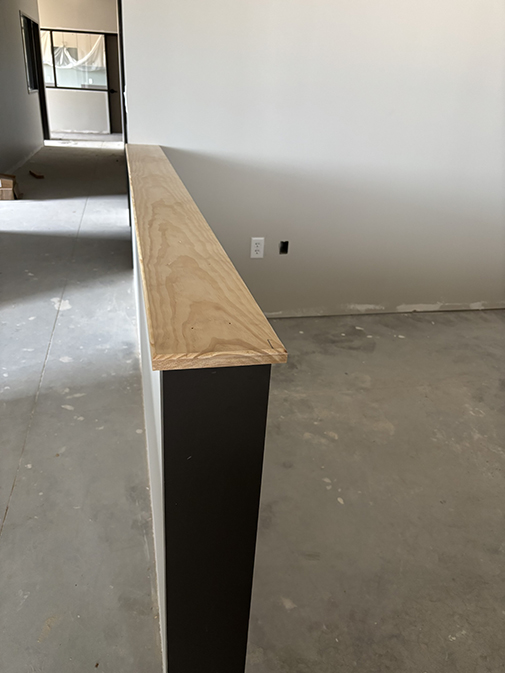

5.15.22 - The project consists of erecting 4 buildings for the Closner Equipment Co.
The buildings are Office, Warehouse, Repair Bays, and a Wash Bay.
Total is about 6.5 acres with new grading, drainage, and paving plan. Lot will be fenced with automatic gates installed.
Detention pond had 858 cubic yards of dirt removed per the civil engineering plans for the offset of drained water. This portion of the project is complete.
6.02.22 - Crewmen are addressing punch out items and the project will be completed by next week,
5.11.22 - This project is complete. Waiting on power,
3.18.22 - The stucco is complete. The ceiling grid installation is underway, and the electricians are installing the lights,
3.02.22 - Crews have made great progress this month. The paving is complete and masonry has begun. Interior crews continue to hang sheetrock,
2.15.22 - Interior crews are hanging drywall and the concrete crewmen are forming the paving. The excavation of the business park's eastern retention pond is almost complete,
1.19.22 - Erectors are sheeting the roof. Framers are framing the walls.
1.04.22 - Erectors are hanging steel for this new facility,
12.16.21 - Crews are preparing for the foundation pour,
11.11.21 - Site work is underway for a new 20,000 SF trade school, located at 20213 Binford Rd,
6.02.22 - Power was turned on today, allowing the remaining trades to finish their work,
3.03.22 - Interior build out continues. Windows are installed,
2.08.22 - The building is sheeted. Erectors are installing the ridge vents. Framers have completed framing the office walls.
12.22.21 - The foundation was poured today,
7/01/21 - This new 8,600 SF office and warehouse is in permitting. Construction updates will be available on this page, so check back for this location's progress and availablility.
6.02.22 - Power was turned on today. Flooring and the ceiling tile installation will follow,
3.03.22 - Interior framing is underway,
2.08.22 - Erectors began hanging the steel today,
7/01/21 - This new 8,600 SF office and warehouse is in permitting. Construction updates will be available on this page, so check back for this location's progress and availablility.
5.20.22 - Crewmen are pouring the offsite parking lot today,
5.11.22 - Crewmen are forming for the offsite parking lot. The next phases include a warehouse building and paving in the main yard,
This project includes two ground-up spec office/warehouses totaling 43,000 SF. Scope of project also includes extending the business park's private drive and utilities.
3.02.22 - Buildings 4 and 8 are completed,
2.18.22 - Wrapping up work on Buildings 4 and 8,
12.29.21 - Stucco and masonry to begin. Landscaping continues for Bldg 4 and began today for Bldg 8. Electricians are digging up the underground conduit to AT&T's conduit at both bldgs,
12.23.21 - Ceiling tile installation continues for Buildings 4 & 8, fixtures are installed in both buildings, receptacles and can lights are going in today in both buildings, and crews are hooking up the condenser units for Buildings 4 and 8,
12.16.21 - Flooring continues,
11.05.21 - Waiting on one piece of glass to be installed above the door on Building 8. Plumbers are ready for fixtures as soon as the floors are installed. Electrial work continues for both buildings.
10.29.21 - The OH door installation continues for Building 8. Plumbers are also installing the water heater and pipe for Building 8. Electricians continue their work on Buildings 4 and 8,
10.22.21 - Crews cleaned and backfilled around the seven new concrete drainage flumes. Crews are installing lights and ceiling grid in Buildng 4. Waiitng on AC materials for buildings 4 and 8,
9.07.21 - Northwinds crewmen are working to back fill the south side of Bldg 8, next to the drainage ditch, and dress it up. M&M Erectors continue the wall panel installation on Bldg 4,
8.24.21 - Erectors are lifting Bldg #4's roof,
8.18.21 - Paving was poured for Bldg #8. Erectors are lifting Bldg #4,
7.24.21 - Foundation was poured this morning for Bldg #4,
7.02.21 - Crewmen continue to lay out the sub-sub grade in the paving areas around Bldg. 4 & 8, and are cutting to grade to prepare for select fill,
6.25.21 - We are resuming select fill in the paving areas around pad #8. Cutting the paving sub grade in the west end of pad #4 to be able to get a minimum of 8” of select fill and compacted. Plumbers are backfilling trenches.
6.12.21 - Windrowing the select fill on Pad 4 and on Pad 8 to help pull the moisture out. Regrading and compacting to get ready for their test on Monday morning. Working on the ditch on the north side of BLDG. 8. Shaping and grading to drain to the pond inlet.
6.11.21 - Site crewmen are laying down the select fill that was stock piled yesterday on Pad 4 and began laying down the select fill that was stock piled yesterday on Pad 4. Crews started the first lift on pad 8, compacting in lifts. The plumbers continue working on the 8” water tie in and continued digging their trench.
6.10.21 - Site crewmen began the select fill in Pad 4 and are compacting in lifts.
6.09.21 - Crews are cutting bldg. pad 4 & 8 to sub grade (in preparation for select fill). Running the 324 over pad 8 to compact it. Back filling stabilized. Back filling stabilized sand over the 2 culverts. Began the layout and grading on the north side ditch,
6.08.21 - Cutting bldg. pad 4 to sub grade and starting on pad 8 to prepare for select fill. Running the Roller and 324 over pad 4 to compact it.
6.07.21 - Starting the 24” & 15” coverts - excavating to grade, building up hdpe bed with stabilized sand, laying the pipe and back fill to 6” from top of pipe for city inspections. Cutting bldg. pad #4 to sub grade to prepare for select fill.
1.26.22 - This was such a fun project. Below are final photos of their new church,
11.20.21 - This project is nearing completion. Floor installation is underway, as interior painting continues. Start-up crewmen are installing AC units. The final clean and completion are scheduled for next week,
11.10.21 - Electricians are tieing in homeruns and pulling wire into the sanctuary, bathroom tile installation continues, and masons continue bricking the exterior. Erectors began trimming the building and plumbers set 5 septic tanks,
10.19.20 - The ceiling grid is installed and door frames are being installed,
10.15.21 - The electricians are pulling wire as additional crews clean the site and reset the silt fence. The data wire is also being run.
9.12.21 - The glass is installed. Drywall, electrical, and HVAC work continue,
9.02.21 - Framers are hanging drywall. HVAC crewmen are hanging the ductwork,
8.24.21 - The exterior walls are up and interior framing and buildout are underway,
8.04.21 - Erectors have progressed to hanging the pre-assembled roof sections,
8.02.21 - Erectors are into their second day hanging steel,
7.23.21 - The foundation is cured and saw cut. Steel delivery is scheduled for tomorrow,
7.22.21 - Crews began pouring the foundation for the church building this morning,
7.01.21 - Crews laid out form boards, and finished digging grade beams. Electricians are working on underground electrical for the foundation.
6.30.21 - Electricians are laying out the underground electrical,
6.26.21 - The plumbers continue underground plumbing,
6.24.21 - Underground plumbing continues,
6.22.21 - Crewmen cleared shrubs along the drive for the future sign. Additional crews spread lime to speed the drying time of the job site, and laid out grade beam locations,
6.18.21 - Crewmen drilled and poured piers. Electricians installed conduit for light poles.
5.14.21 - Curbs were poured for the parking area and have cured,
4.27.21 - Crewmen are pouring the parking areas today,
3.16.21 - Crewmen continue their work on the pond outfall, digging out the second box, with stabilization, rest box and pipe, backfill, and dress up,
1.12.21 - Site crewmen continue excavating the detention pond and grading the site,
12.23.20 - Crews are clearing the site to prepare for the church's building pad,
Sitework will soon begin for Connect Church's new 12,000 SF facility. The new church facility will include a sactuary, class rooms, and administrative offices,
8.24.21 - The sidewalk extension is complete for the Word of God Christian Fellowship Church congregation,
7.16.21 - Photos of the completed project,
6.25.21 - Crews finished addressing the punch out items for this project.
6.23.21 - Hanging generator enclosure doors and painting.
6.04.21 - Prepping for Generator pad pour,
6.02.21 - Electrical final called in for tomorrow.
6.01.21 - Started dropping ceiling tile and began final clean. Fire Marshall performed visual and hydro test. Approved to cover ceiling.
5.29.21 - Electricians are hanging lights, hanging new exterior wall packs
5.26.21 - Passed ADA inspection. Restroom stall doors are hung with hardware installed,
5.25.21 - Flooring crews are setting core base and addressing punch items. Fire Marshall visual is scheduled for June 1st. Furniture delivery is scheduled for June 7th.
5.24.21 - Electricians are labeling and tracing circuits. Concrete crew in to form and pour lab trough.
5.20.21 - Painters are painting out the walls. Plumber added a check valve on the circulating line. Electricians installed wiremold and plates.
5.19.21 - Crews are setting all window blinds. Painters are painting out all walls.
5.17.21 - Restroom mirrors are installed. Bad gaskets have been relaced on exterior windows. Glass sidelites are set. Electricians are setting devices. Painters are applying final coat.
5.14.21 - Crews are installing lavatories in break room and the copy room. Plumbers are finishing their fixture installations. Electricians are setting two fixtures in the restrooms,
5.04.21 - Electricians are tying in the lights. Sprinkler heads are being installed. Tile installation is underway in the restrooms and front store wall. Carpet is being installed on the West side.
5.03.21 - HVAC removed the existing rooftop units (RTUs) and set new RTUs. They also ran condensate lines, insulated vav's and copper linesets. Electricials set light fixtures and dropped whips into fixtures, and set pub panels in the electrical room. Fire sprinklers are being installed on grid, and the ceramic tile is being installed in the restrooms, and west office areas. The roofers started cricket on the North side, and are repairing the roof areas in the NE corner,
4.28.21 - Plumbing and Electrical rough-in are complete. Walls are taped and floated. Drywall crew are installing the ceiling grid. IT contractor is running data cabling,
3.16.21 - Crewmen began hanging duct work, and are saw cutting areas of slab to be removed for plumbing and electrical,
3.11.21 - This project includes remodeling 9,188 SF of office, 273 SF of lab space, and 679 SF of warehouse.
4.20.21 - The rock and concrete work are completed. Fence installation and clean up remain.
4.05.21 - Crewmen continue cutting grade,
3.26.21 - Site crew began scraping for a new rock yard at 4121 Katy Hockley Rd. This is part of the new tenant’s improvemnets,
2.06.20 - This project is complete,
12.15.19 - The building is fully trimmed. Flooring began in the entry,
12.03.19 - Painting is complete and flooring will soon follow,
10.05.19 - Sheeting is underway,
9.27.19 - Parking lot is poured. Erectors are hanging steel,
9.24.19 - Crews are erecting the building. More paving has been poured,
9.12.19 - The building pad was poured and crews are forming for additional paving,
7.16.19 - Crews are pouring the main drive,
7.11.19 - Crewmen began building the pad and laying out the private road for the business park,
6.28.19 - Sitework is underway for this new 9,300 SF office/warehouse, located off Katy Hockley Road and Clay Road. This new facility is available for Sale or Lease,
