8.23.24 - Fire inspections are underway. The epoxy flooring is complete,
8.19.24 - Kitchen equipment installation and electrical trim out work continues,
8.13.24 - Kitchen work continues. The warehouse is clean and epoxy flooring will follow.
8.09.24 - Sign installation is underway. The kitchen is nearing completion,
8.07.24 - Kitchen equipment installation continues,

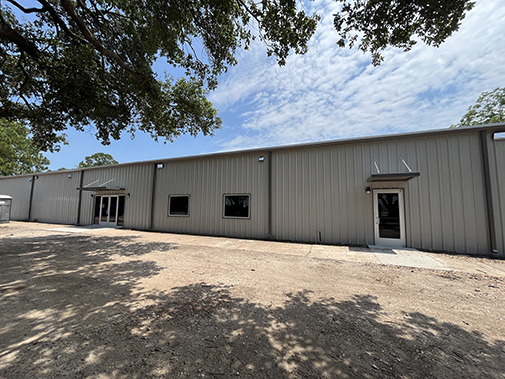

8.06.24 - Electrical work continues, flooring is nearing completion, the exterior canopy is installed,
7.30.24 - Parking curbs are installed, flooring continues, and restroom partition installation is nearing completion,
7.26.24 - Flooring continues,
7.22.24 -
7.17.24 - Painting continues,
7.16.24 -
7.12.24 - Lights are on,
7.10.24 -
7.02.24- Inspections are complete and requirements are met, so ceiling tile installation and final clean will follow,
6.28.24 - Kitchen equipment arrived, restroom partitions are in place, and the final painting is complete,
6.17.24 - Tile installation is underway,
6.10.24 - Exterior trim is complete. Ceiling grid installation is complete. Electricians trim out the interior,

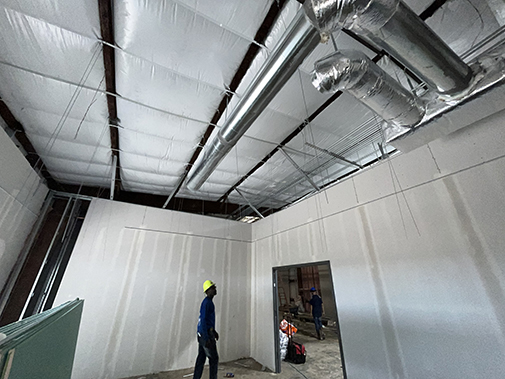

5.08.24 - Crews are taping, floating, and sanding interior walls,
4.26.24 - Plumbers are roughing in the plumbing as additional crews begin sheetrocking the interior walls,

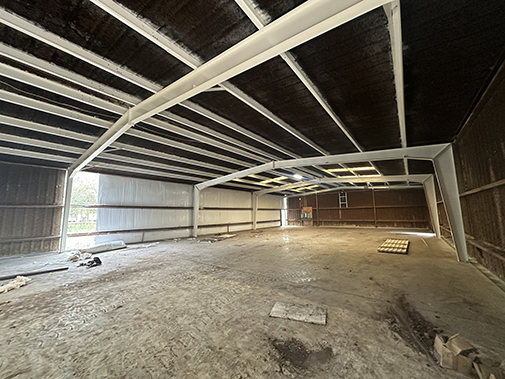

3.01.24 - Warehouse steel painting is complete. Crews are currently installing the insulated metal wall panels,
2.01.24 - Interior buildout demolition continues,
12.04.23 - MEP interior demolition is underway,
This project includes the renovating of an existing 10,000 SF warehouse for commercial kithcen use.
